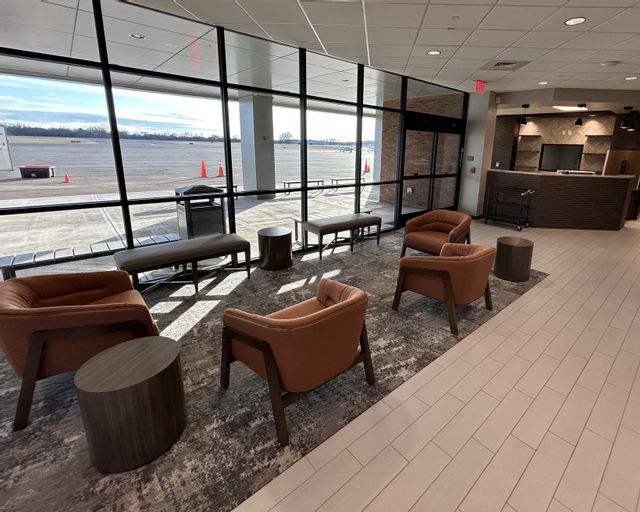

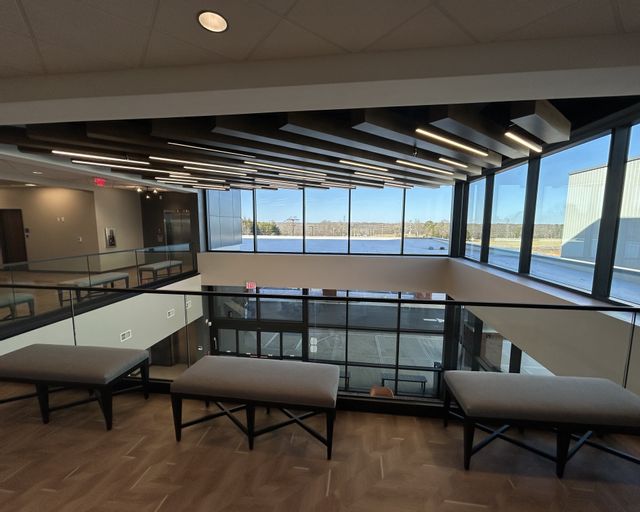

Statesville Regional Airport Terminal Building

Progress continues on the new terminal building at the Statesville Regional Airport.

The ribbon cutting ceremony has been rescheduled to March 26, 2026. Learn more about the ribbon cutting here. Exterior metal panels have arrived and are currently being installed. A meeting with the exterior signage company is scheduled for next week to finalize signage details.

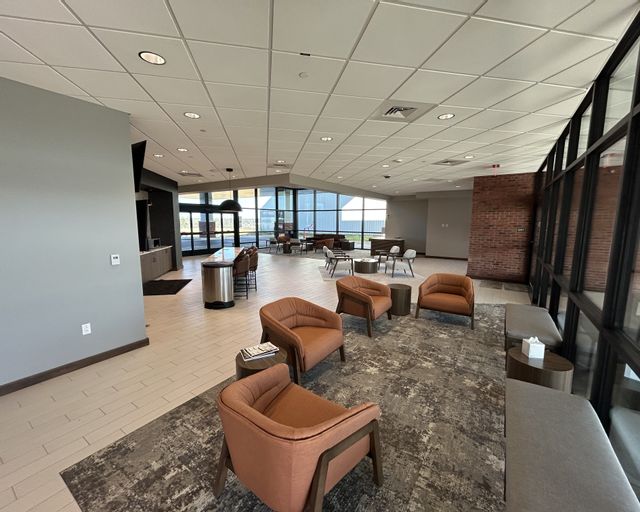

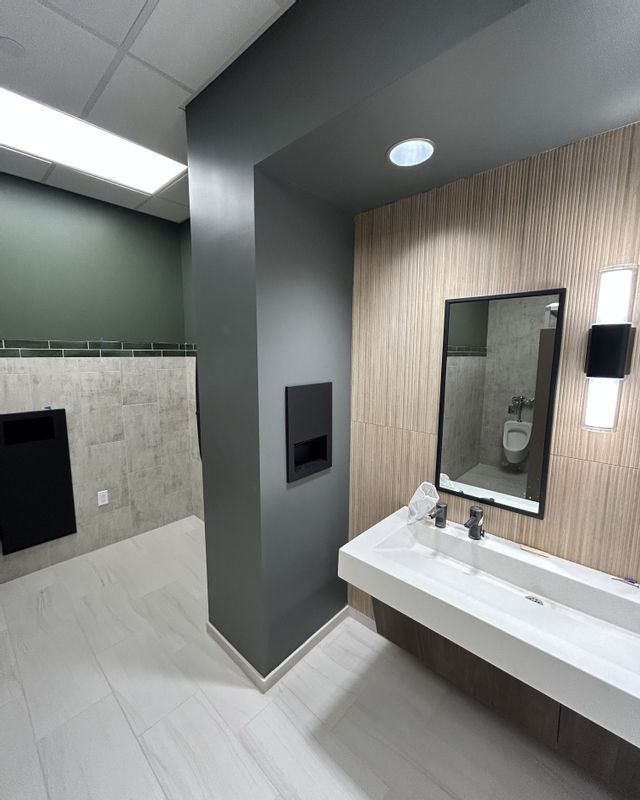

Several minor interior punch list items are being addressed. A final exterior punch walk will be conducted once the metal panel installation is complete.

Work continues on the new Airport Terminal Building as the project moves into its final stages. Crews are wrapping up remaining punch list items and completing finishing touches throughout the building.

Long lead-time metal panels are expected to arrive in mid to late February 2026 and will be installed once delivered. The original flagpole shipment arrived with the wrong finish and is being returned. The correct flagpole was delivered late last week, and installation is currently underway.

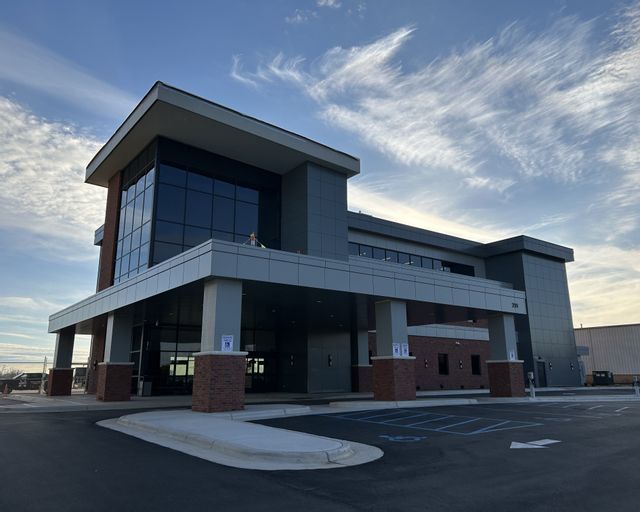

The ribbon cutting ceremony remains scheduled for February 9, 2026, as planned - and we can’t wait to celebrate this milestone with you!

Grand Opening & Ribbon Cutting Ceremony

đź“… February 9, 2026 at 2pm

📍 Statesville Regional Airport (238 Airport Rd)

đź”— Learn more here.

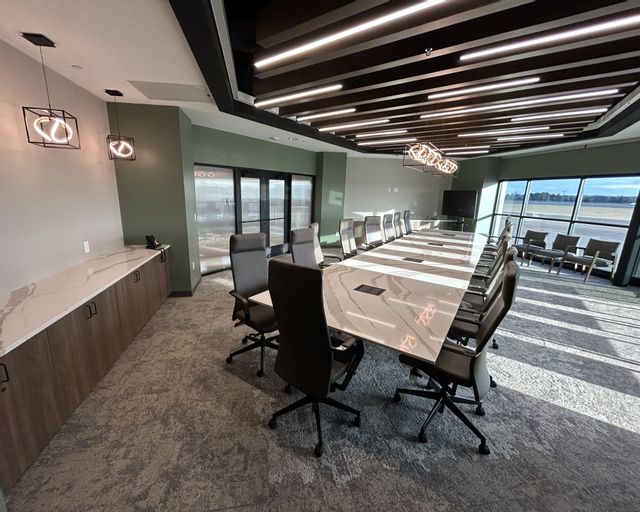

The new terminal building at the Statesville Regional Airport reached a major milestone with the issuance of a Temporary Certificate of Occupancy (TCO) on December 19, 2025.

All major construction tasks have been completed. A small number of minor items remain, including installation of metal panels needed to wrap exterior columns. These panels had a longer lead time and are expected to be installed once received.

The current plan is to hold a ribbon cutting ceremony on February 9, 2026. Additional details will be shared as the event approaches.

Project Update: December 2025

Construction of the new Statesville Regional Airport Terminal Building continues to move forward, with the contractor targeting substantial completion by December 15, 2025. Once the project reaches substantial completion, the City of Statesville will be granted a Temporary Certificate of Occupancy (TCO), allowing the building to begin limited operations.

Final punch list items are expected to be completed between late January and early February 2026.

There are a few areas of the project that are awaiting custom metal panels with extended lead times. These panels are strictly cosmetic and will not impact the issuance of the final Certificate of Occupancy.

Pending final completion, the City of Statesville is hopeful to host an official grand opening toward the end of February 2026.

The Statesville Regional Airport Terminal Building Project is nearing completion, with major milestones now in sight. The final lift of asphalt has been installed in the parking lot, marking one of the last major exterior construction activities.

The project is on track for substantial completion by mid-December. Although metal panels for the lobby and exterior columns have been delayed until early February 2026, this delay will not affect the Certificate of Completion or the building’s readiness for opening.

A plaque unveiling ceremony for City Council is currently scheduled for December 1, 2025, with an official Grand Opening event planned for mid to late January 2026.

Project Update: October 3, 2025

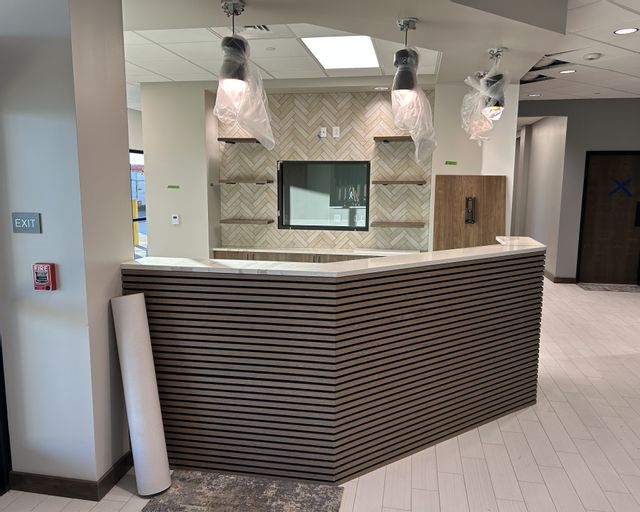

The Airport Terminal Building project is making steady progress and is scheduled for substantial completion by December 9, 2025, with all punch list items expected to be finished by early February 2026.

Recent work includes completing sidewalks, taxiway paving, and exterior panel installation. Inside, crews are insulating walls, installing bathrooms, electrical systems, and other key building components. Landscaping, drainage work, and parking lot improvements are also underway.

The building is quickly taking shape inside and out, bringing the project closer to opening.

Project Update: August 26, 2025


Construction on the Statesville Regional Airport Terminal Building continues to make strong progress with several major components nearing completion.

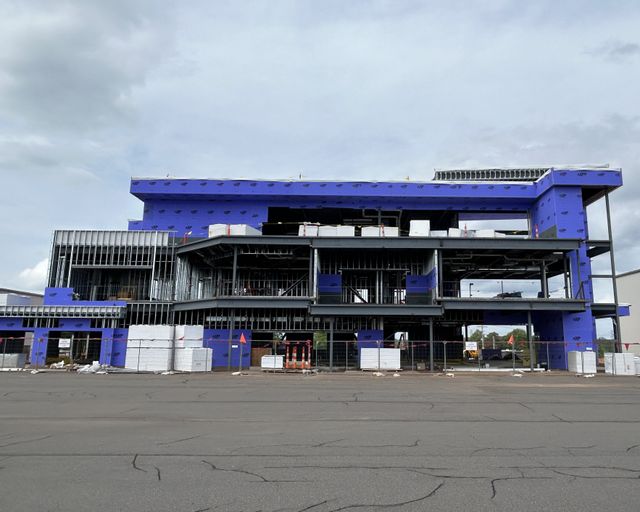

The 3rd floor balcony roof is complete, elevators and rough-in electrical work are substantially finished, and crews are advancing with guard rail posts, drywall, and framing for curtain walls.

Insulation for exterior metal panels is being installed, the booster pump is in place, and fire protection is 95% complete.

Site improvements are also moving forward, including curb and gutter work, stormwater pond clearing, and ongoing cleanup.

Upcoming milestones include the installation of knock-down doors, completion of the main stair railings, and setting of the generator.

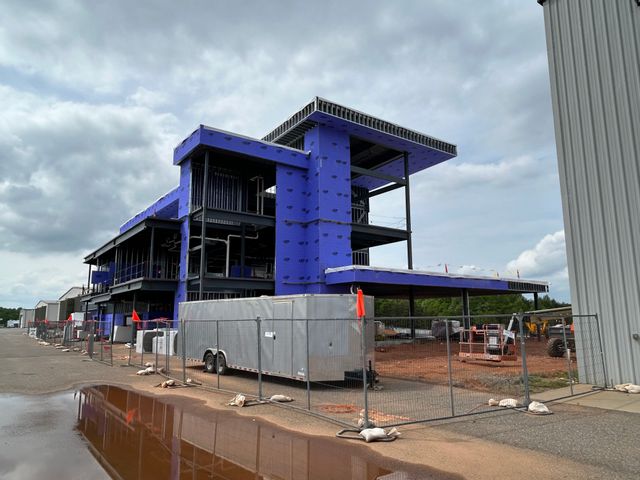

While the substantial completion date has been adjusted to December 16, 2025, to allow for storefront installation that will keep the building weather-tight, the project remains on track to deliver a modern, functional terminal that will serve the community for years to come.


Update: August 1, 2025

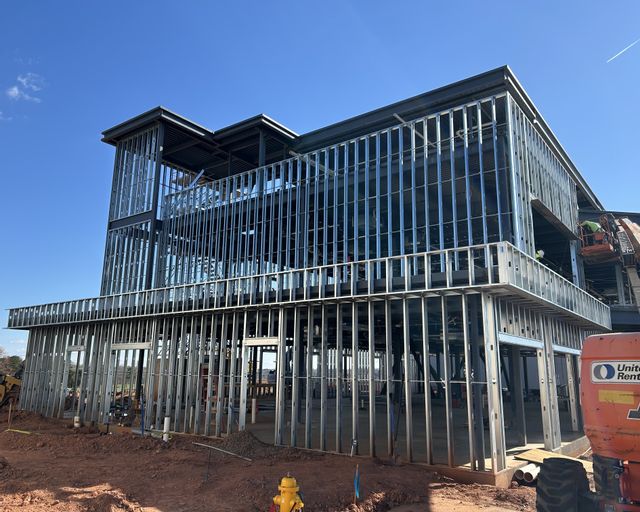

Construction on the new terminal building continues to progress steadily with major advancements both inside and out.

Recent Progress Highlights:

  • Installation of curb and gutter has begun for the parking lot.
  • Curtain wall and storefront frame installation is ongoing, with glass setting now underway.
  • Roof installation for the second-floor balcony is in progress.
  • Cable guard rail post bases have been installed on the balconies.
  • Service stairs are complete, and the main stair is nearing completion.
  • The weather-resistant barrier is substantially finished.
  • Installation of the fire pump has started.
  • Underground electrical rough-in is complete for the parking lot pole lights, EV chargers, monument sign, and pull boxes.
  • Interior wall topping out with drywall has started.

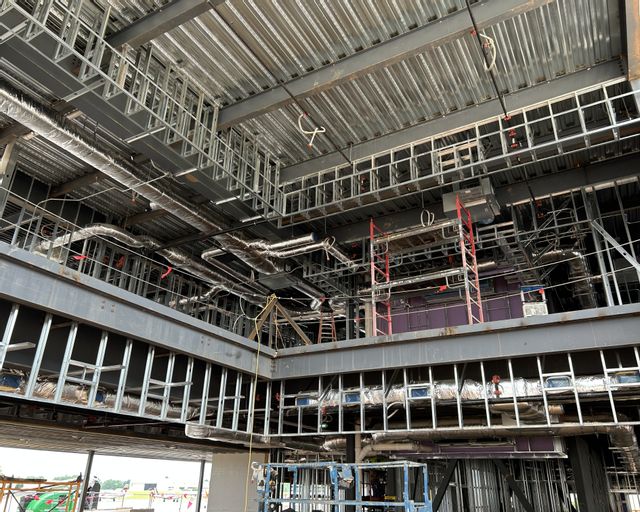

  • Mechanical, electrical, and plumbing (MEP) overhead and in-wall rough-ins are nearly complete.
  • Electrical rough-in work has begun for elevator shafts (Cars 1 & 2).
  • The electrical room build-out is underway.

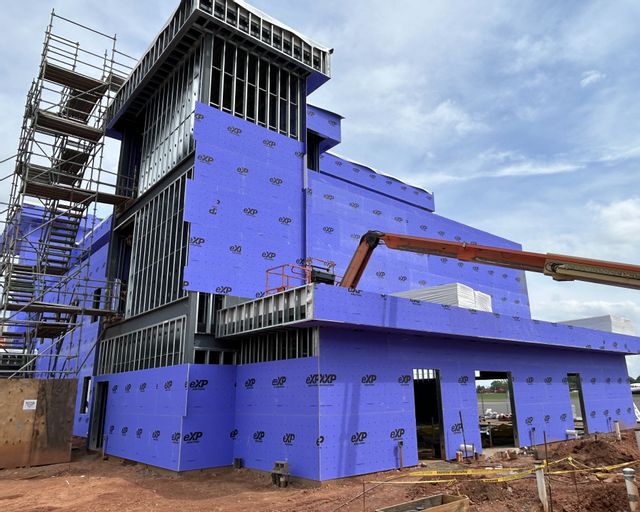

  • Exterior masonry cladding is substantially complete.
  • Wire is being pulled for lighting, and spray foam insulation is finished at all window and door heads and jambs.

What’s Coming Up Next:

  • Interior drywall hanging and interior wall insulation will begin.
  • Curtain wall and storefront framing will be completed.
  • Fire pump and elevator electrical rough-in work will be finalized.
  • Curb and gutter installation will be completed.
  • Crews will begin placing the stone base and asphalt base coat in the parking lot.
  • Sidewalk installation will begin.
  • Roofing will begin on the third-floor balcony.
  • Exterior hollow metal door installation will begin.
  • The building’s generator will be set in place.

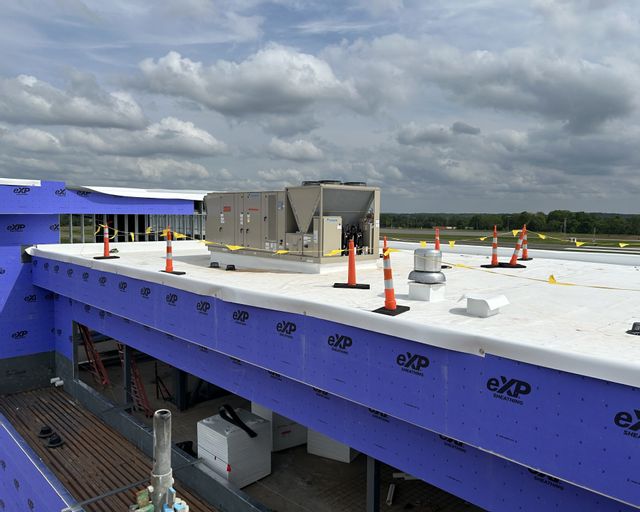

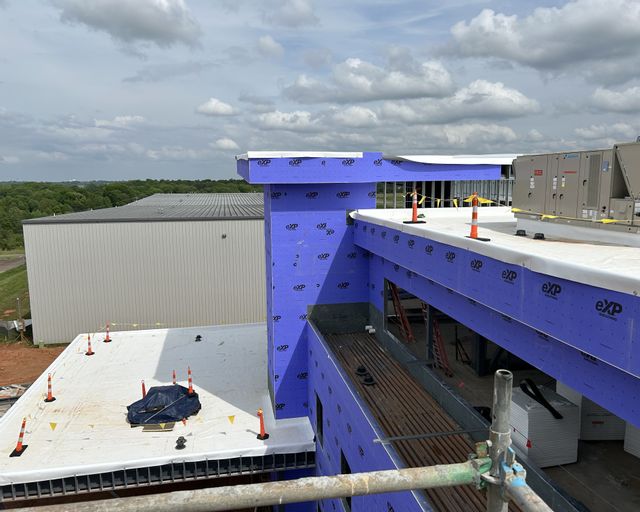

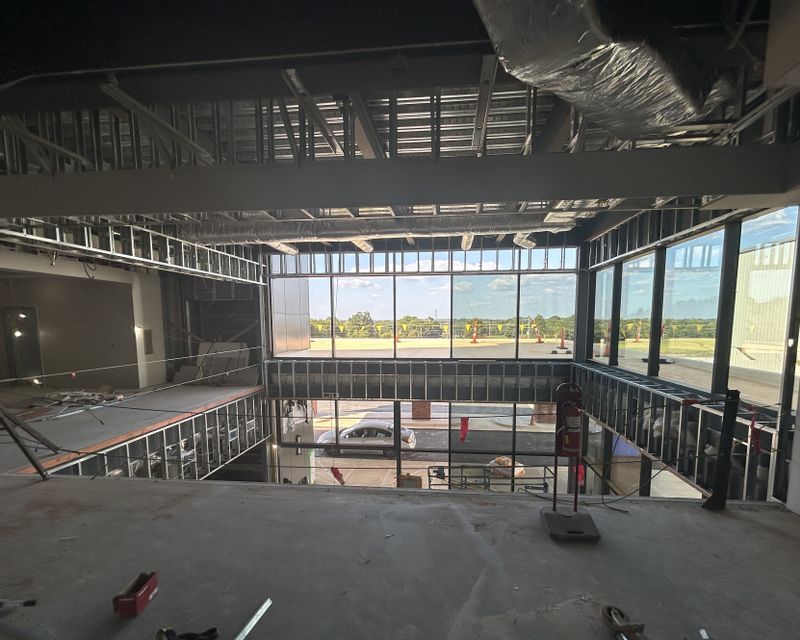

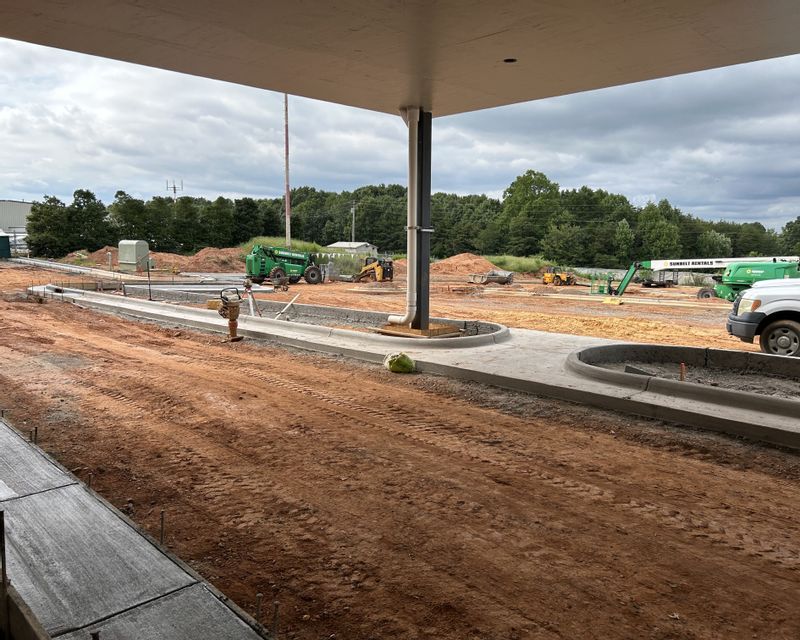

View images below:

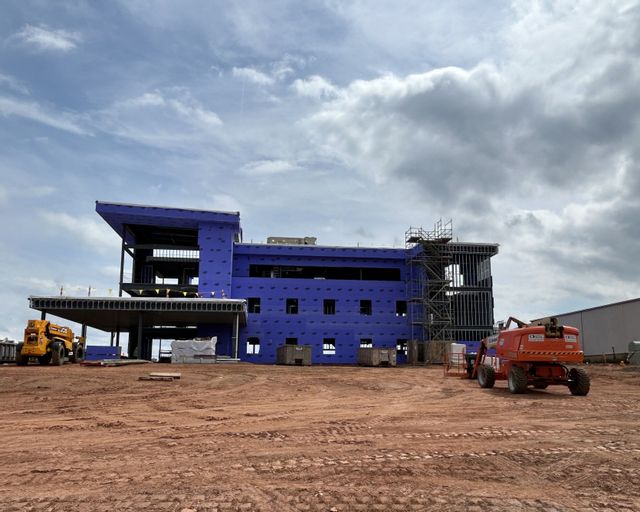

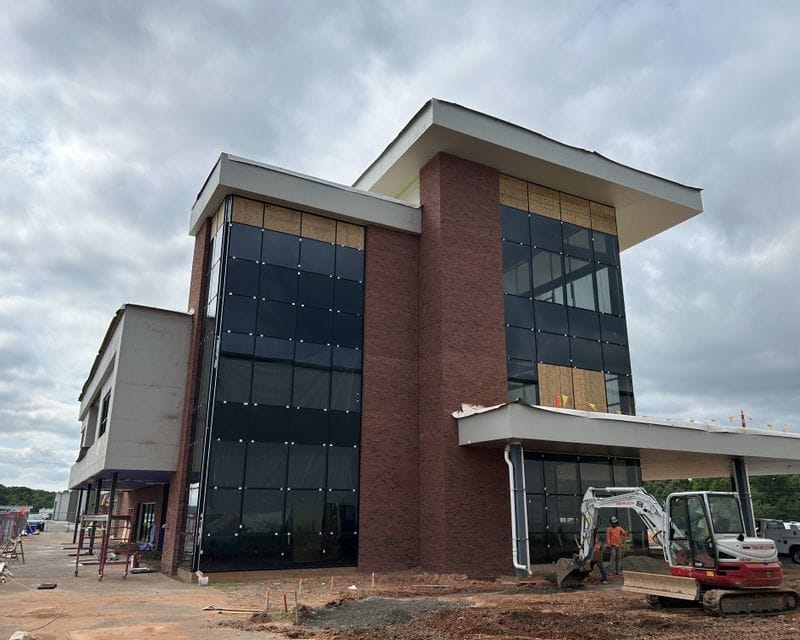

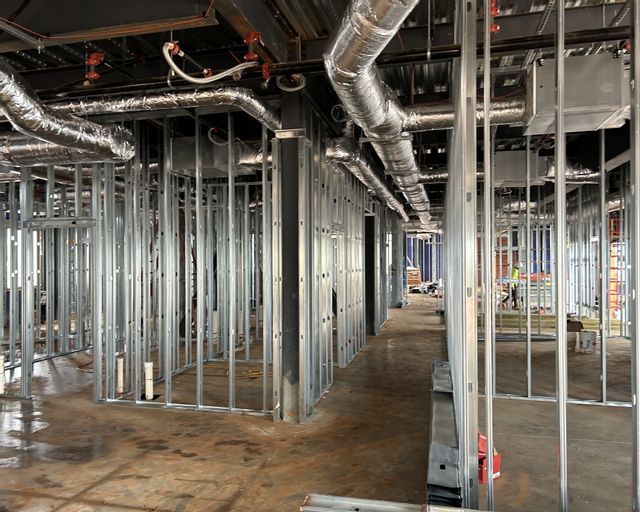

Construction of the new Statesville Regional Airport Terminal Building is making steady progress. Most of the brickwork on the building is nearly finished, and crews are continuing with work around the site. Workers are installing support materials for the rooftop walls, and the large glass curtain walls and front windows are also being built.

The transformer and underground systems that will power the building are in place, and the second elevator shaft is mostly complete. Inside, framing for the rooms and offices is coming along well. Ventilation for the first-floor bathrooms is being installed, and the stairwells are starting to take shape. One of the biggest tasks right now is finishing the rough installation of plumbing, electrical, and HVAC systems on the first floor. Outside, crews plan to finish preparing the parking lot curbs this week. The project team has also reviewed inspection requirements to stay on track.

Because of delays in getting some of the metal panels needed for the exterior, the expected completion date has been moved to December 18, 2025.

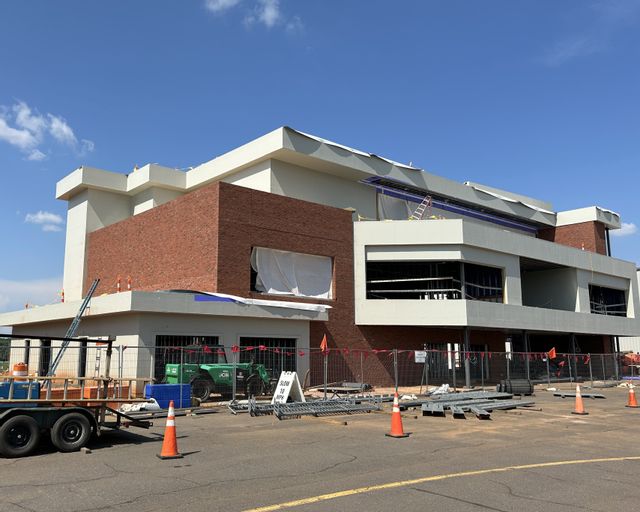

Work on the new terminal at Statesville Regional Airport is moving right along! Here’s a look at what’s happening on-site:

  • Crews have started building the walls below ground level.
  • Brickwork is now underway on the exterior of the building.
  • A few pieces of flashing (used to keep water out) are still on the way, but most of the building is being sealed up.
  • The City of Statesville has finished running underground pipes and wiring where needed.
  • Lights are being installed under the first-floor canopies.
  • The elevator shaft has been insulated to help with temperature and noise control.
  • Support beams (called headers) have been put in place to hold parts of the structure.
  • A few minor issues with wall framing were found, but they’ve already been fixed.

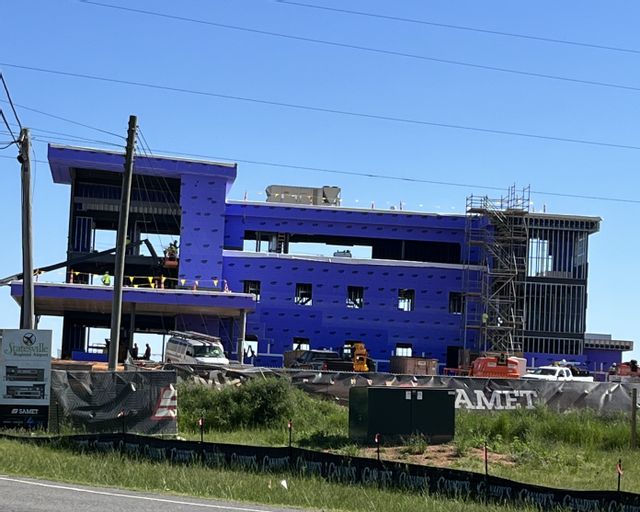

  • About 75% of the walls on the lower level are framed and taking shape.
  • The concrete floors (called the “slab on grade”) have been smoothed out and approved—we’re just waiting on a final warranty letter.
  • Pipes on the roof that carry away rainwater are being wrapped in insulation to protect them.
  • Plumbing work inside the building is continuing steadily.
  • The concrete pad for the generator will be poured sometime next week.

We’re excited about the progress and will continue to share updates as this project moves forward. Check back soon for more!

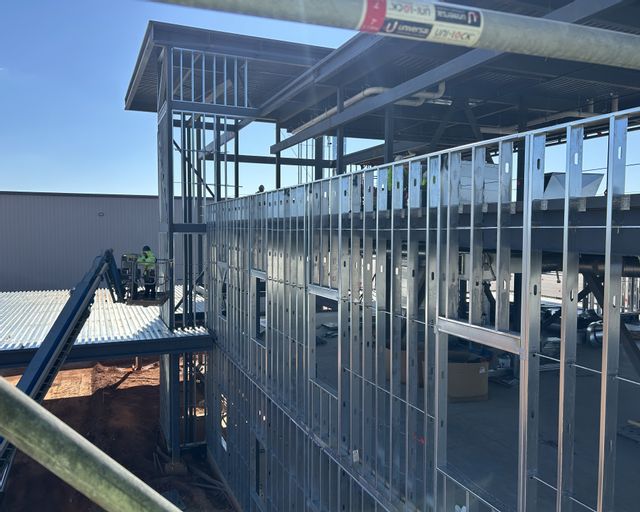

Progress continues at the Statesville Regional Airport Terminal Building:

  • Exterior light gauge framing is complete.
  • Installation of exterior sheeting is approximately 75% complete.

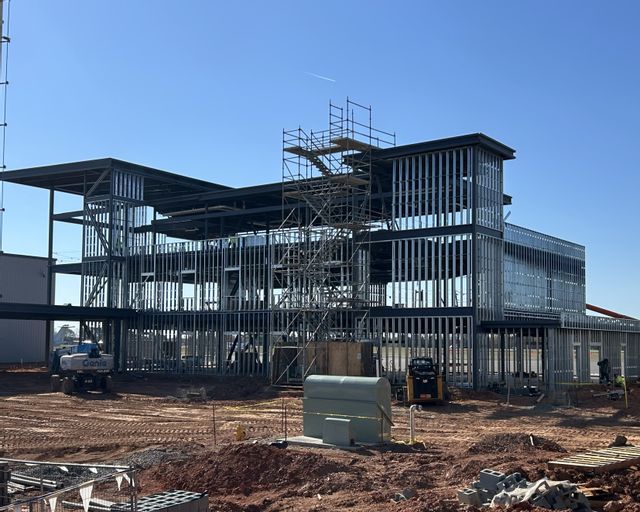

  • Interior framing is 60% complete.

The project remains on schedule for completion by the end of 2025 or very early in 2026.

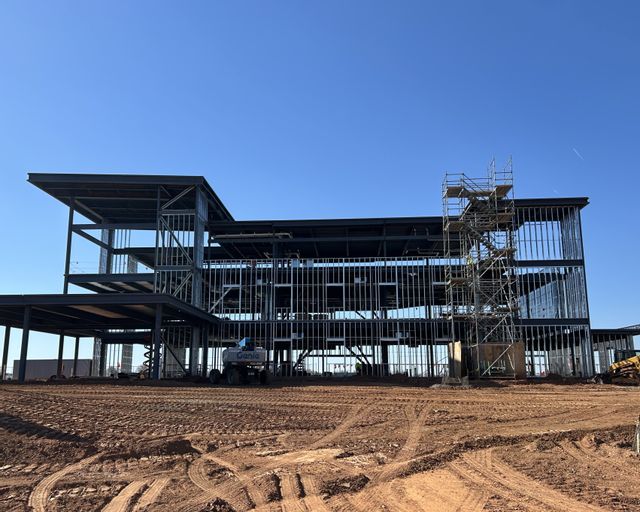

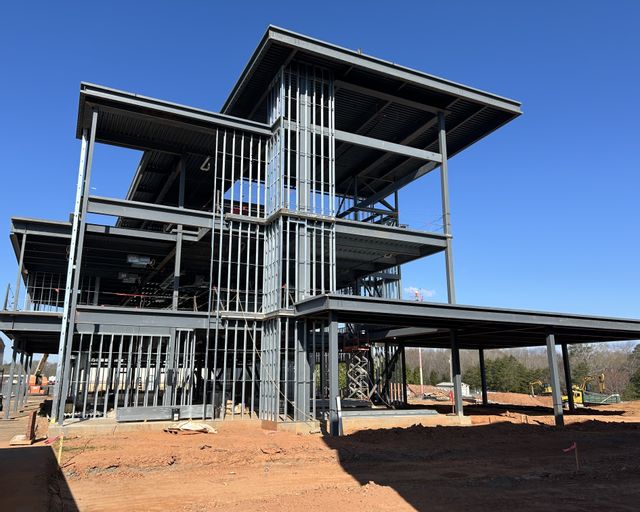

Construction on the new Airport Terminal Building continues to make steady progress. Crews are actively working on fill dirt placement in the lower parking lot and are focused on drying the area to stay on track. Exterior framing is moving along, and 704 Steel is addressing heavy steel framing components. A site walk with the roofing contractor is scheduled for Monday, March 31, 2025, and roof curbs for exhaust fans and roof top HVAC units are expected to be installed by the end of the week. The existing stormwater pond has been cleared and cleaned out, and roof drains have been completed. Inside the building, sprinkler installation is nearing completion. Interior wall framing is progressing in sequence, beginning with the second floor, followed by the third, and then the first floor.

The City of Statesville is investing in the future of air travel with the construction of a new three-level airport terminal at 238 Airport Road. This state-of-the-art facility will enhance the experience for pilots, travelers, and businesses utilizing the Statesville Regional Airport, a key transportation hub in the region.

Key Features

  • Expanded Terminal Area – Increased space to accommodate more passengers and improve operational efficiency.

  • Office Spaces for Future Growth – Additional office areas designed to support the airport’s long-term expansion.

  • Restaurant Space on the Third Floor – A designated area for a potential restaurant, which could generate revenue for the City of Statesville while providing an additional amenity for travelers.

Project Timeline & Investment

  • Start Date: June 2024

  • Anticipated Completion: January 2026

  • Estimated Cost: $15 million

Funding Sources

Funding for the terminal’s construction is sourced from NC Department of Aviation grants, the City of Statesville, and Iredell County, reflecting a joint commitment to regional growth and transportation infrastructure.


Why This Project Matters

The Statesville Regional Airport plays a crucial role in economic development, supporting corporate travel, business aviation, and regional air transportation. This new terminal will not only modernize the facility but also position Statesville as a premier aviation hub, attracting new businesses and opportunities for growth.
